Facade Inspection & Safety Program (FISP) | Cycle 10
What is FISP?
New York City’s Façade Inspection & Safety Program (FISP) requires all buildings greater than six stories to undergo an exterior wall inspection by a Qualified Exterior Wall Inspector (QEWI) every five years.
Who can be a QEWI?
A QEWI must be a Registered Architect (RA) or licensed Professional Engineer (PE) in good standing with the New York City Department of Buildings (DOB) and the New York State Education Department (NYSED), and must have at least seven years of relevant experience with facades over six stories.
FISP Inspection Classifications
After examining the exterior walls and appurtenances, the QEWI files an electronic report in DOB NOW: Safety and assigns one of three classifications:
SAFE – No repairs needed to remain safe for the next five years.
SWARMP (Safe With a Repair and Maintenance Program) – Safe now but requires repair within 1–5 years to prevent becoming unsafe.
UNSAFE – A hazardous condition requiring immediate protective measures and repair within one year.
Unsafe Conditions
If a building is classified UNSAFE, the QEWI must specify public protection (e.g., sidewalk shed or fencing), which the owner must install immediately.
Unsafe conditions must be corrected within 30 days, with an amended report submitted within 15 days of completion. If repairs take longer, the QEWI may request a time extension of up to 90 days, provided the site is secured. Additional extensions may be granted for unforeseen circumstances or extensive repairs.
A filing fee applies for each extension, which must be renewed until all Unsafe conditions are resolved.
FISP Sub-Cycles
The current cycle, Cycle 10, runs February 21, 2025 – February 20, 2030.
A building’s sub-cycle (A, B, or C) is determined by the final digit of its tax block number - please see below to determine when the report must be filed.
Sub-Cycle 10A
Tax block numbers ending in 4, 5, 6, or 9.
Filing Period: Feb 21, 2025 – Feb 21, 2027.
Sub-Cycle 10B
Tax block numbers ending in 0, 7, or 8.
Filing Period: Feb 21, 2026 – Feb 21, 2028.
Sub-Cycle 10C
Tax block numbers ending in 1, 2, or 3.
Filing Period: Feb 21, 2027 – Feb 21, 2029.
Owners who fail to file a technical report within the specific filing period are subject to a monthly late penalty until an acceptable report is approved by the Department of Buildings.

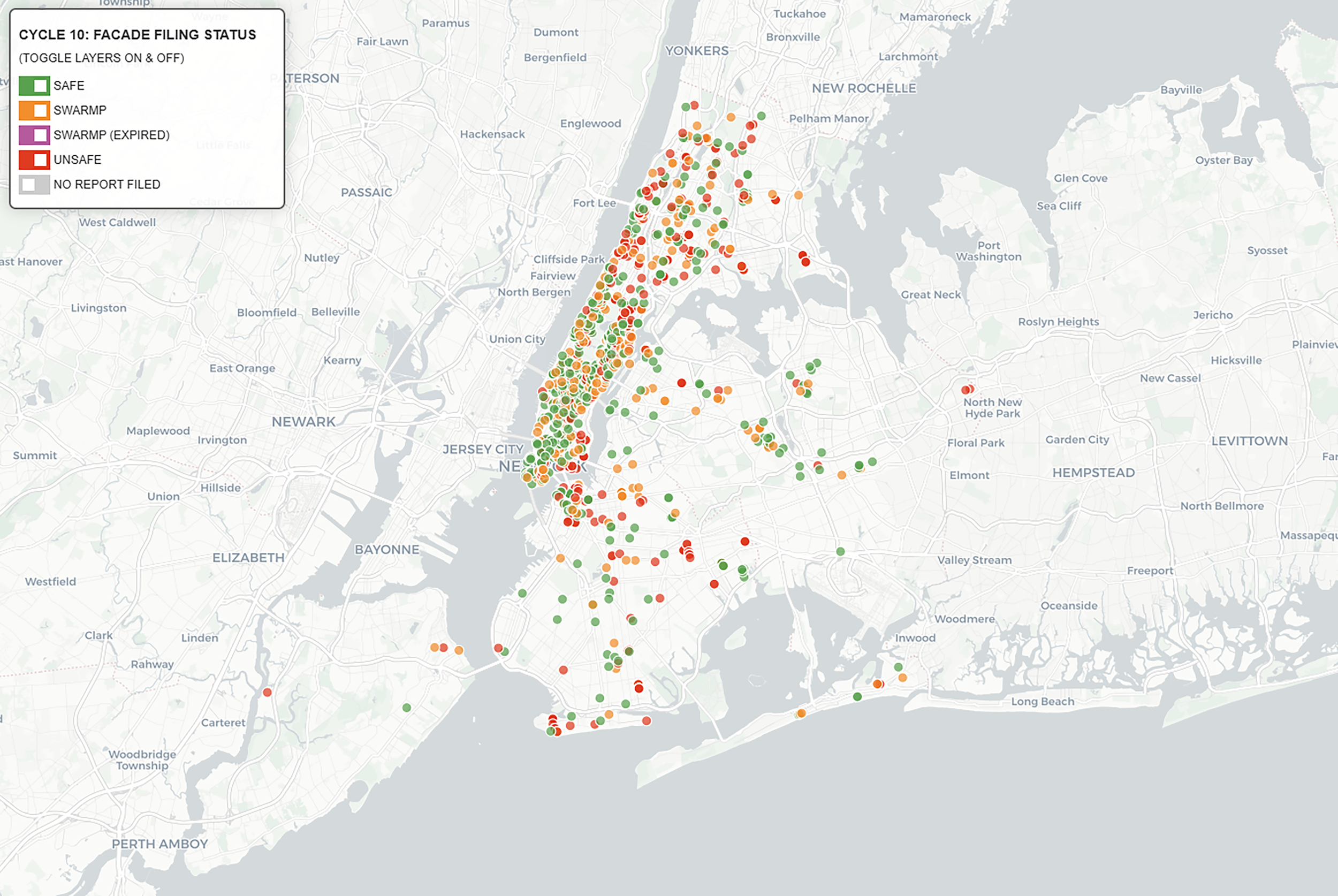

Click here for the DOB FISP map.
Find your building’s tax block number here.

FISP Cycle 10 Filing Fees
Initial Report: $425
Amended/Subsequent Report: $425
Extension Request: $305
Click here for current DOB Facade Fees & Penalties.
FISP Challenges
Common Challenges for Building Owners
Understanding how to start the FISP process and file a report
Determining when building permits are required
Knowing what types of public protection are acceptable
Avoiding or minimizing DOB violations and fines
We help make FISP easier to understand and navigate, offering clear guidance and quick communication and drone inspections for areas that are difficult or costly to access.
Contact us to set up your FISP plan and inspection.
